Shipping & Delivery Speed

Shipping & Delivery Speed

You can have the best engineers, the cleanest architecture, and the most elegant code in the world. None of it matters if it sits in staging. Features in staging don't make money. Features in staging don't solve customer problems. Features in staging are inventory — and inventory is waste.

Your job as a team leader is to get working software into the hands of users as fast as humanly possible, without breaking things. This is not about rushing. It is about removing everything that stands between "idea" and "in production" that doesn't need to be there.

This guide will teach you how.


1. Why Speed Matters

Let's start with the blunt version: speed is a competitive advantage and it compounds.

If your team ships a feature in one week and your competitor's team ships a similar feature in six weeks, you are not 6x faster. You are infinitely faster for those first five weeks because you are generating value and they are generating nothing. Over a year, you ship roughly 50 improvements while they ship roughly 8. After two years, the gap is so wide it's nearly impossible to close.

This is not theory. This is observable in every market. The companies that win are not always the ones with the best ideas. They are the ones that execute fastest, learn fastest, and iterate fastest.

Speed also changes how your team feels. Teams that ship regularly have higher morale. They see their work in production. They get feedback from real users. They feel momentum. Teams stuck in long cycles feel like they're on a treadmill — working hard, going nowhere.

There's a psychological concept here worth knowing: progress is the single biggest motivator at work. Not compensation, not perks, not even praise. The feeling of making progress. And nothing creates a sense of progress like seeing your code in production, serving real users, solving real problems.

As a team leader, your delivery speed is the most visible signal of your team's health. Executives may not understand your architecture decisions or your technical trade-offs, but they absolutely understand "how fast does this team ship?" It is the first thing they look at and the last thing they forget.

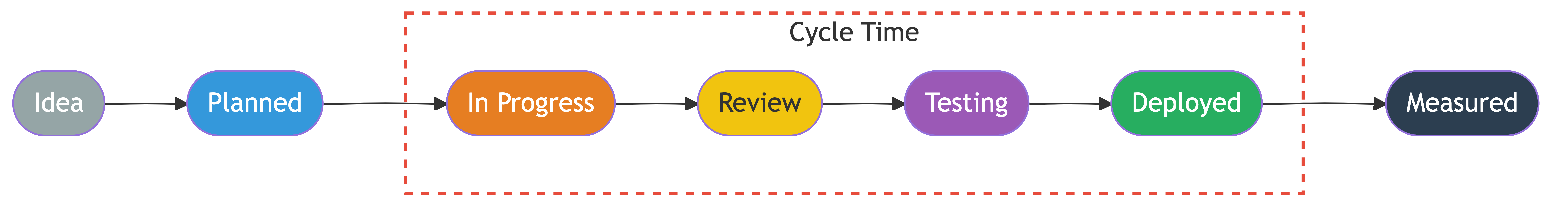

2. Cycle Time

If you only track one metric as a team leader, make it cycle time.

Cycle time is the elapsed time from when work starts to when it's in production. Not when the PR is merged. Not when it's deployed to staging. When a real user can use it.

This is different from lead time, which measures from when work is requested to when it's delivered. Lead time includes the time a ticket sits in the backlog waiting to be picked up. That matters too, but cycle time is the part you have the most control over.

Here's how to measure it:

The simple version: Look at the timestamps. When did the engineer pick up the ticket? When was the feature live in production? Subtract. That's your cycle time.

The slightly better version: Break cycle time into stages and measure each one:

  • Coding time — from first commit to PR opened
  • Review time — from PR opened to PR approved
  • Merge-to-deploy time — from PR merged to live in production
  • Waiting time — all the gaps in between where nothing is happening

That last one is the killer. In most teams, work spends more time waiting than being worked on. Waiting for review. Waiting for QA. Waiting for the next deploy window. Waiting for someone to answer a question. Waiting for a dependency team to do their part.

What good looks like:

  • Elite teams: cycle time under 1 day for most changes
  • Strong teams: cycle time of 1-3 days
  • Average teams: cycle time of 1-2 weeks
  • Struggling teams: cycle time of weeks to months

If your cycle time is measured in weeks, you have a significant problem. Something in your process is broken, and finding that bottleneck is your highest priority.

How to track it:

  • If you use Jira or Linear, the data is already there. Track the time between status changes.
  • GitHub and GitLab can show you time from first commit to merge.
  • Tools like Jellyfish, LinearB, and Sleuth automate cycle time tracking.
  • If you have none of that, a spreadsheet works. Track the last 20 tickets manually. You'll see the pattern immediately.

The conversation to have with your team: Put the numbers on a dashboard. Make them visible. Review them weekly. Don't use cycle time to judge individuals — use it to find systemic problems. When a ticket took eight days, ask "what happened?" with genuine curiosity. Usually the answer reveals a blocker you can fix.


3. Removing Blockers

This is your number one daily job. Not code reviews. Not architecture decisions. Not sprint planning. Removing blockers.

Every hour an engineer is blocked is an hour of salary spent producing nothing. For a team of six engineers, even one blocked engineer for one day costs the company 500500-800 in wasted salary alone, not counting the opportunity cost of delayed delivery.

Blockers come in four categories:

Technical Blockers

  • A flaky test suite that makes CI unreliable
  • A staging environment that's broken
  • Missing API documentation from another service
  • An unclear data model or schema question
  • Infrastructure provisioning that requires a ticket to another team

How to unblock: Fix the immediate problem yourself if you can do it in under an hour. If you can't, escalate immediately. Don't wait for the next standup. Don't wait for the right Slack channel to respond. Walk over, call, DM the person who can unblock it. Your engineer's time is burning while you wait politely.

Process Blockers

  • PRs sitting unreviewed for more than a few hours
  • Mandatory approvals from people who are in back-to-back meetings
  • Deployment windows that only happen on Tuesdays
  • Change approval boards that meet once a week
  • Mandatory QA sign-offs with a three-day turnaround

How to unblock: Challenge every process that adds wait time. Ask "what is the worst thing that happens if we skip this step?" If the answer is "nothing, we've always done it this way," kill the process. If the answer is "we had an incident two years ago," ask whether there's a faster way to get the same safety guarantee. Usually there is.

People Blockers

  • A key person is on vacation and no one else has context
  • A decision needs to be made and no one wants to make it
  • Two engineers disagree on an approach and are at a stalemate
  • A team member is struggling with a task but hasn't asked for help

How to unblock: Build redundancy by ensuring at least two people have context on every critical system. Make decisions quickly — a good decision now beats a perfect decision next week. When two engineers are stuck in a debate, give them 30 minutes to present their cases, then make the call. When someone is struggling silently, notice it in standup and offer pairing time.

External Dependencies

  • Waiting on another team to ship an API
  • Waiting on a vendor to fix a bug
  • Waiting on legal or compliance to approve a design
  • Waiting on a customer to provide test data

How to unblock: This is the hardest category. You often can't make external teams move faster. What you can do: plan around dependencies early, mock external APIs so your team can keep building, escalate through your manager when another team's timeline is blocking your deliverables, and always have a "plan B" ticket ready so engineers can switch to productive work while waiting.

Your daily routine should include this: At every standup, listen specifically for blockers. After standup, spend the first hour of your day unblocking people. Track blockers in a simple list. Follow up relentlessly. A blocker that was mentioned Monday and is still there Wednesday is your failure, not the engineer's.


4. Reducing Work in Progress (WIP)

Here is a counterintuitive truth that most new leaders get wrong: the fastest way to get more done is to do fewer things at once.

This feels wrong. It feels like if everyone is busy, you're being efficient. But busyness and productivity are not the same thing. In fact, they're often opposites.

Little's Law

There's a mathematical principle that governs this, and it's called Little's Law. It says:

Average cycle time = Work in progress / Throughput

In plain English: the more things you have in flight at the same time, the longer each one takes to finish. This is not an opinion. It is math.

If your team has a throughput of 5 tickets per week and you have 10 tickets in progress, each ticket takes an average of 2 weeks. If you reduce WIP to 5 tickets, each one takes 1 week. Same throughput. Half the cycle time. Features reach users twice as fast.

Why WIP Kills Speed

Context switching. Every time an engineer switches between tasks, they lose 15-25 minutes of productive focus. An engineer working on three things simultaneously doesn't produce 3x output. They produce maybe 1.5x output while taking 3x as long on each one.

Hidden queues. When there are 15 tickets "in progress," there's no visibility into what's actually being actively worked on versus what's sitting in someone's mental backlog. The board looks busy. Nothing is moving.

Delayed feedback. When an engineer has three PRs open, all waiting for review, the feedback from the first PR comes back after they've already moved on mentally. They have to context-switch back, re-read the code, re-load their mental model. This is enormously wasteful.

How to Implement WIP Limits

Start simple: each engineer should have at most two things in progress at any time — the thing they're actively working on and one thing in review.

When someone finishes a task and wants to pull a new one, check the board first. If another engineer has a PR waiting for review, the first priority is reviewing that PR, not starting new work. Stop starting. Start finishing.

If your team uses a Kanban board, put explicit WIP limits on each column. If your "In Review" column has a limit of 3 and there are already 3 items there, no one can move new work into that column until something moves out. This creates healthy pressure to review and ship existing work.

Your team will resist this at first. Engineers like to feel busy. They'll say "but I'm blocked on that PR so I need something else to work on." That's fine — but the answer is to unblock that PR, not to start a third stream of work.


5. Continuous Delivery Practices

These are the specific engineering practices that enable fast delivery. You don't need to implement all of them at once, but you should be working toward all of them.

Small Pull Requests

This is the single highest-leverage practice change most teams can make.

A 50-line PR gets reviewed in 10 minutes. A 500-line PR gets reviewed in a day — if it gets reviewed at all. Large PRs are intimidating, so reviewers put them off. When they finally review, they're less thorough because their attention spans are exhausted. The result is worse quality AND slower delivery.

Target: 90% of PRs should be under 200 lines of meaningful changes. If an engineer says their feature can't be broken into smaller PRs, that's almost always a design problem, not a feature problem. Help them find the seams.

Feature Flags

Feature flags let you merge code to main and deploy to production even when the feature isn't ready for users. The code is there, but it's behind a flag that's turned off. When it's ready, you flip the flag. If something goes wrong, you flip it back. No rollback. No hotfix. Just a configuration change.

This is transformative because it decouples deployment from release. Your team can deploy every day — multiple times a day — without coordinating with product or marketing or anyone else about "release dates."

Trunk-Based Development

Long-lived feature branches are where delivery speed goes to die. A branch that lives for two weeks accumulates merge conflicts, drifts from main, and becomes increasingly risky to merge. The merge itself becomes a project.

In trunk-based development, everyone merges to main at least daily. Branches live for hours, not weeks. Merge conflicts are tiny and trivial. The main branch is always in a deployable state.

This requires feature flags (so half-finished work doesn't break production) and good test coverage (so you catch breakage immediately). But once you have those, trunk-based development dramatically accelerates delivery.

Automated Testing

You cannot ship fast without automated tests. Period. If your team relies on manual QA, your delivery speed is capped by the QA team's bandwidth, and there's a multi-day wait baked into every feature.

The goal is a test suite that runs in under 10 minutes and catches 95%+ of regressions. This means investing in fast, focused unit tests and a smaller number of integration tests. Avoid slow, flaky end-to-end tests that take 45 minutes and fail randomly. Those tests destroy confidence in the pipeline and train engineers to ignore failures.

CI/CD Pipeline

Your CI/CD pipeline should do the following with zero human intervention:

  1. Run all tests on every PR
  2. Block merge if tests fail
  3. Auto-deploy to production after merge to main (or with one click)

If any of those steps require a human to do something manually — trigger a build, run a deploy script, update a configuration — you have friction that will slow every single ticket. Automate it.

The gold standard: an engineer merges a PR and sees it in production within 15 minutes with no manual steps. If your pipeline takes longer than that, figure out why and fix it.


6. The Cost of Delay

This is how you communicate delivery speed to business stakeholders in language they understand.

Cost of delay is the revenue or value lost for every unit of time a feature isn't shipped.

Here's a concrete example. Your team is building a checkout optimization that's projected to increase conversion by 2%. Your company processes 500,000inmonthlytransactions.A2500,000 in monthly transactions. A 2% improvement is 10,000 per month in additional revenue. That's 2,500perweek.Thats2,500 per week. That's 357 per day.

Every day that feature sits in a review queue or waits for a deploy window costs the company 357.Everyprocessthataddsadaytoyourcycletimecosts357. Every process that adds a day to your cycle time costs 357. Every meeting that delays an engineer from finishing that feature costs a proportional amount.

Now multiply that across all the features your team ships in a quarter. If you could ship everything one week faster, you'd capture one additional week of value from every feature. For a team shipping 12 features a quarter with an average value of 2,000/weekeach,shippingoneweekfasterisworth2,000/week each, shipping one week faster is worth 24,000 per quarter. $96,000 per year. From one team.

How to Calculate It

For revenue features: Weekly cost of delay = Expected annual revenue impact / 52

For efficiency features: Weekly cost of delay = Hours saved per week x Average fully-loaded hourly cost

For risk/compliance features: Weekly cost of delay = Probability of incident x Cost of incident / Weeks until deadline

You don't need precise numbers. Rough estimates are enough to prioritize and to justify investments in delivery speed. When you tell your VP "every week we delay this feature costs us approximately $3,000," you are speaking their language. When you follow up with "and I can cut two weeks from our cycle time by investing three days in CI/CD improvements," you've just made a business case that's almost impossible to argue with.


7. Batch Size

Batch size is closely related to WIP, but it's about the size of each individual piece of work rather than how many pieces are in flight.

The rule: smaller batches are almost always better.

Think about it this way. If you ship one large feature after three months of work, you get feedback once. If you ship 12 small increments of that same feature over three months, you get feedback 12 times. Each round of feedback lets you course-correct. By the end of three months, the incrementally-shipped version is almost always better than the big-bang version because it's been shaped by real user behavior instead of assumptions.

Smaller batches also reduce risk. A 50-line change that breaks production can be identified and fixed in minutes. A 5,000-line release that breaks production turns into an incident investigation that takes hours or days. The debugging surface area is proportional to the batch size.

The Batch Size / Speed Relationship

Here is the dynamic most people miss: small batches aren't just faster to ship individually — they make everything around them faster too.

  • Smaller code changes are faster to write
  • Smaller PRs are faster to review
  • Smaller deploys are faster to validate
  • Smaller rollbacks are faster to execute
  • Smaller changes produce fewer merge conflicts
  • Smaller changes have fewer bugs

Every step in your delivery pipeline has a cost that scales with batch size. When you cut batch size in half, you don't cut total time in half — you often cut it by more than half because you eliminate the nonlinear overhead that comes with complexity.

How to Make Batches Smaller

When an engineer presents a plan to build something over two weeks, ask: "What's the smallest useful increment we could ship in two days?" Sometimes the answer genuinely is "nothing — this is foundational work that has to be done all at once." But more often, there's a thinner slice that delivers partial value early.

Train your team to think in terms of vertical slices — small pieces that cut through every layer of the stack and deliver something a user can see or use — rather than horizontal layers like "build the database schema, then build the API, then build the UI."


8. Meetings and Process Tax

Every meeting on your team's calendar is time not spent shipping. I want you to internalize this fully.

A one-hour meeting with six engineers doesn't cost one hour. It costs six engineer-hours. At a fully-loaded cost of 100/hour,thatmeetingcost100/hour, that meeting cost 600. If it happens weekly, it costs 31,200peryear.Isthatmeetinggenerating31,200 per year. Is that meeting generating 31,200 in value? For most recurring meetings, the honest answer is no.

The Calendar Audit

Do this exercise in your first month as a team leader: print out every recurring meeting on your team's calendar. For each one, answer these questions:

  1. What decision or outcome does this meeting produce?
  2. Could that outcome be achieved asynchronously (a Slack thread, a doc, a recorded video)?
  3. Does everyone in the meeting need to be there?
  4. Could this meeting be 15 minutes instead of 30, or 30 instead of 60?

Be ruthless. Most teams have 5-10 hours per week of meetings that could be eliminated or shortened without any negative impact.

Common Time Wasters

The status meeting. If people are reading their updates out loud, that should be a written update in Slack or your project management tool. Standups should be about blockers and coordination, not status. If your standup takes more than 10 minutes for a team of six, something is wrong.

The "alignment" meeting. Usually a sign that documentation is poor or decision-making authority is unclear. Fix the root cause instead of meeting about it repeatedly.

The "just in case" invite. Engineers get invited to meetings because "they might have useful context." Instead, let them skip it and send them a summary. Their time writing code is almost always more valuable.

Sprint ceremonies that take all day. If your sprint planning, review, and retro together consume more than three hours, you're over-processing. Cut each one in half and see what breaks. Usually nothing.

Protecting Maker Time

Engineers need blocks of at least 2-3 uninterrupted hours to do deep work. A calendar with meetings scattered throughout the day — one at 10, one at 11:30, one at 2 — is a calendar that produces almost zero deep work despite looking "mostly free."

Consolidate meetings into one or two days. Protect the other days as meeting-free. This is one of the most impactful things you can do for your team's output.


9. Real-World Examples

Scenario 1: The Weekly Shippers

Team Alpha is a six-person team at a mid-stage startup. They practice trunk-based development with feature flags. Their CI/CD pipeline deploys to production on every merge to main. PRs are typically under 150 lines and get reviewed within 2 hours. Their cycle time averages 1.5 days.

In a given quarter, Team Alpha ships 45-50 incremental improvements to their product. They get user feedback constantly. When something doesn't work, they know within days and adjust. Their product manager has a direct line between "hypothesis" and "validated learning" that takes about two weeks end to end.

The result: Team Alpha's product has improved dramatically over the past year. User satisfaction scores are up. Revenue from their product area is up 34%. The team's morale is high — they feel like they're making real impact.

Scenario 2: The Quarterly Release Team

Team Beta is also a six-person team at a similar company. They work in three-month release cycles. Features are developed on long-lived branches. QA happens in a two-week phase at the end of the cycle. Deploys happen once a quarter through a change management process.

In that same quarter, Team Beta ships one release containing 8-10 features. But three of those features need immediate hotfixes because bugs that would have been caught with incremental delivery made it through. Two features turn out to be things users don't actually want — but the team won't get that feedback until after the release, and they won't be able to act on it until the next cycle.

The result: Team Beta's product has stagnated. User satisfaction is flat. Revenue growth is minimal. The team is demoralized — they work hard for three months and then watch their release go sideways. Two senior engineers have left in the past year, citing "inability to move fast."

Scenario 3: Same Team, Different System

Team Gamma was performing like Team Beta. Their cycle time was 18 days. They had a weekly deploy window. PRs averaged 400 lines and sat in review for 2-3 days.

Their new team leader made three changes over two months:

  1. Implemented a WIP limit of 2 items per engineer
  2. Set a team norm that PRs must be reviewed within 4 hours
  3. Worked with DevOps to enable daily deploys instead of weekly

No new hires. No new tools. No reorganization. Just process changes.

Cycle time dropped to 4 days. Throughput went from 6 tickets per sprint to 10 tickets per sprint — a 67% increase. The team shipped more in the following quarter than they had in the previous two quarters combined.

This is not unusual. Most teams are not slow because they lack talent. They are slow because their processes are slow.


10. Common Mistakes

Shipping Fast but Breaking Things

Speed without reliability is not speed. If you ship a feature on Monday and it causes an incident on Tuesday, the time spent on incident response, hotfixes, customer communication, and trust repair easily exceeds the time you "saved" by shipping without adequate testing.

Fast delivery requires investment in automated testing, monitoring, and rollback capabilities. If you don't have these, building them is your first priority — even before you try to accelerate delivery.

Cutting Corners on Quality

This is the close cousin of the above. When a leader pushes for speed, engineers sometimes hear "skip tests, skip code review, ship whatever compiles." This is your fault if it happens. Be explicit that speed comes from process improvements and smaller batches, not from lower quality bars.

A useful phrase: "We ship fast because we ship small, not because we ship sloppy."

Ignoring Tech Debt for Speed

There's a tempting pattern: skip the refactor, hardcode the value, copy-paste instead of abstracting, take on the tech debt now and "pay it back later." And sometimes that's the right call. But if you do this consistently, delivery speed actually decreases over time because every new feature has to navigate a growing maze of shortcuts.

Think of tech debt like financial debt. A small, strategic loan to seize an opportunity is smart. Living permanently on credit cards is not. Budget 15-20% of your team's capacity for tech debt reduction, and treat it as non-negotiable.

Not Measuring

If you don't measure cycle time, you can't improve it. Intuition is unreliable — a team that "feels" fast might actually have a two-week cycle time because they're confusing being busy with being productive. Start measuring. The numbers will surprise you.


11. Speed vs. Quality

This is the most important section of this guide, because the biggest misconception in software engineering is that speed and quality are at odds.

They are not. Speed and quality reinforce each other when you do it right.

Here's why:

Small changes have fewer bugs. If you ship 50-line PRs instead of 500-line PRs, each change is simpler, easier to review, and less likely to contain defects. Quality goes up.

Fast feedback catches problems early. If you deploy daily, you find bugs within hours of writing the code. The engineer still has full context and fixes it quickly. If you deploy monthly, bugs are found weeks later, the engineer has to re-learn their own code, and the fix takes 5x longer. Quality goes up.

Automated testing enables speed. A good test suite lets you ship with confidence. You don't need a manual QA phase because the tests catch regressions automatically. Quality and speed go up simultaneously.

Small batches reduce blast radius. If a 50-line change breaks something, you know exactly what broke and why. If a 5,000-line release breaks something, you're debugging in the dark. Quality goes up because recovery is faster.

The teams that ship the fastest in the industry — Google, Amazon, Netflix, Spotify — also have some of the highest quality bars. That's not a coincidence. Their speed comes from the same practices that enable quality: small changes, automated testing, continuous deployment, feature flags, and fast rollbacks.

The real trade-off is not speed vs. quality. It is speed vs. the illusion of control. Long release cycles, heavy approval processes, and extensive manual testing feel safe. They give stakeholders the feeling that everything has been checked. But that feeling is an illusion — because the longer you wait to ship, the more risk you've accumulated, and the harder it is to find and fix problems.

The safest way to deploy is frequently, in small increments, with automated checks and fast rollback. It doesn't feel as safe to people unfamiliar with the practice. Part of your job as a team leader is building that trust.


Business Value

Let's talk concrete numbers.

Revenue Impact of Faster Shipping

Consider a product team at a company doing 10Minannualrecurringrevenue.Theteamownsaproductarearesponsibleforabout10M in annual recurring revenue. The team owns a product area responsible for about 3M of that revenue. They ship features that drive growth and retention.

Current state: Average cycle time of 14 days. The team ships about 6 significant improvements per quarter. Average revenue impact per feature: ~$5,000/month after adoption.

Improved state: Average cycle time of 3 days. The team ships about 15 significant improvements per quarter. Same average revenue impact per feature.

In the current state, after one year of shipping (24 features), the compounding monthly revenue gain is approximately 120,000/yearfromnewfeatures.Intheimprovedstate(60features),itsapproximately120,000/year from new features. In the improved state (60 features), it's approximately 300,000/year. That's $180,000 in additional annual revenue, and it compounds every year because those features keep generating value.

But it gets bigger. Faster cycle time means faster learning. When the team can validate an idea in days instead of weeks, they kill bad ideas sooner and double down on good ones sooner. The quality of features shipped — not just the quantity — improves because of tighter feedback loops. Conservative estimates put this learning dividend at an additional 20-30% in value.

Efficiency Gains

A team of 6 engineers with a total compensation cost of $1.2M/year. Here's what delivery speed improvements look like in efficiency terms:

Reducing PR review wait time from 24 hours to 4 hours: Each engineer loses approximately 30 minutes of context-switching per delayed PR. With an average of 3 PRs per engineer per week, that's 1.5 hours per engineer per week recovered. For 6 engineers, that's 9 hours/week or roughly $28,000/year in recovered productivity.

Cutting cycle time from 14 days to 3 days: This doesn't mean engineers work less. It means less time is wasted on context-switching between stale tasks, re-reviewing old code, resolving merge conflicts, and re-testing after long delays. Conservative estimate: 15% productivity gain, or $180,000/year equivalent.

Eliminating 5 hours/week of unnecessary meetings: At 100/hourfullyloaded,thats100/hour fully-loaded, that's 500/week per engineer affected. Across 6 engineers: $156,000/year.

Reducing incidents caused by large, risky deploys: If large quarterly deploys cause an average of 2 significant incidents per year, each costing 40 engineer-hours to resolve plus customer impact, switching to small daily deploys typically reduces incidents by 60-80%. Estimated savings: 50,00050,000-80,000/year in incident costs alone.

Cost of Slow Delivery

Here is the uncomfortable math. If your team's cycle time is 14 days when it could be 3 days, you are paying for 11 days of waste per feature. Not wasted effort — your engineers are working hard during those 11 days. But wasted time: the feature is sitting in a queue, waiting for review, waiting for deployment, waiting for approval, or being reworked because of stale feedback.

For a team that ships 80 features a year, that's 880 days of waste. At a rough cost of 500/engineerday,thats500/engineer-day, that's **440,000/year in delivery that could have happened sooner.**

And the revenue that could have been earned during those delay days? For features averaging 500/weekinvalue,shippingeachone11dayssoonercapturesanadditional 500/week in value, shipping each one 11 days sooner captures an additional ~785 per feature. Across 80 features, that's $62,800/year in additional revenue.

Measurable Outcomes

When you invest in delivery speed, here's what you should expect to measure after 3-6 months:

Metric Before After Impact
Cycle time 10-14 days 2-4 days 3-5x faster time to value
Deploy frequency Weekly or less Daily or more Smaller risk per deploy
PR review time 24-48 hours 2-4 hours Reduced context switching
Features shipped per quarter 6-8 15-20 2-3x more value delivered
Change failure rate 15-20% 5-8% Fewer incidents, less rework
Engineer satisfaction (survey) 6/10 8/10 Better retention
WIP per engineer 3-4 items 1-2 items Focus and faster completion

These numbers are based on industry data from the DORA (DevOps Research and Assessment) metrics program and are consistently reproducible across teams that commit to the practices in this guide.

The bottom line: investing in delivery speed is one of the highest-ROI activities a team leader can undertake. It improves revenue, reduces costs, increases quality, and makes your team happier. There is no downside.


Where to Go from Here

Start measuring. This week. Pick your last 10 tickets and calculate the cycle time for each one. Find the median. Find the outliers. Ask what caused the slowest ones to be slow.

Then pick one thing from this guide — just one — and implement it. Maybe it's WIP limits. Maybe it's a PR review SLA. Maybe it's cutting a meeting. Make one change, measure the impact, and iterate.

You'll find that delivery speed is a flywheel. One improvement makes the next one easier. Faster reviews lead to smaller PRs. Smaller PRs lead to faster deploys. Faster deploys lead to more confidence. More confidence leads to more frequent shipping. More frequent shipping leads to faster feedback. And faster feedback leads to better products.

Get the flywheel spinning. Everything else follows.


Common Pitfalls

  • Shipping fast by cutting quality. Speed without reliability is not speed. If you ship Monday and cause an incident Tuesday, the time spent on incident response, hotfixes, and trust repair exceeds what you "saved." Fast delivery requires investment in testing, monitoring, and rollback capabilities.
  • Ignoring tech debt in pursuit of speed. Taking on shortcuts consistently causes delivery speed to decrease over time as every new feature must navigate a growing maze of workarounds. Budget 15-20% of capacity for tech debt reduction and treat it as non-negotiable.
  • Not measuring cycle time. Without measuring, you cannot improve. Intuition is unreliable, and a team that "feels" fast might actually have a two-week cycle time because they confuse busyness with productivity.
  • Allowing too much work in progress. Having everyone busy on multiple tasks simultaneously feels efficient but actually slows everything down due to context switching. The fastest way to get more done is to do fewer things at once.
  • Letting meetings consume engineering time without auditing them. A one-hour meeting with six engineers costs six engineer-hours. Most recurring meetings could be eliminated or shortened without negative impact, yet teams rarely question them.
  • Confusing deployment frequency with delivery speed. Deploying often is important, but only if what you deploy is small, tested, and valuable. Large, infrequent deployments bundled together for a weekly deploy window accumulate risk and slow feedback loops.

Key Takeaways

  • Speed is a competitive advantage that compounds. Teams that ship frequently learn faster, iterate faster, and deliver dramatically more value over time.
  • Cycle time, the elapsed time from when work starts to when it is in production, is the single most important metric for a team leader to track.
  • Removing blockers is your number one daily job. Every hour an engineer is blocked is wasted capacity.
  • Reducing work in progress through WIP limits is one of the highest-leverage changes most teams can make. Less in flight means faster completion of each item.
  • Small batches are almost always better: smaller PRs get reviewed faster, deploy with less risk, and provide faster feedback.
  • Speed and quality reinforce each other when done correctly. Small changes, automated testing, continuous deployment, and feature flags enable both simultaneously.
  • The cost of delay can be calculated and communicated to stakeholders in business terms, making it a powerful tool for justifying investments in delivery speed.
